Skinner’s Shed is a Council-owned property that we are looking to demolish and start anew with. The site will be levelled for potential future use. The project is due to commence in May 2026 and be complete by Summer 2026.

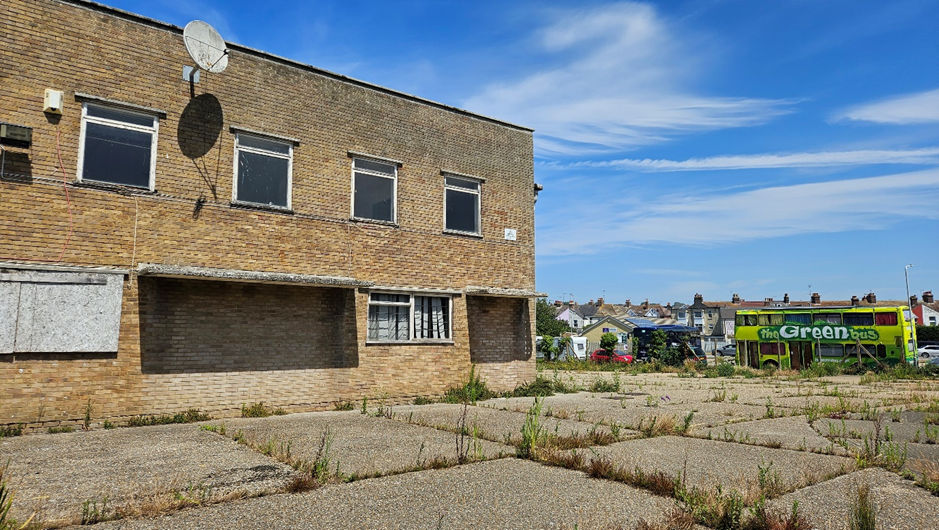

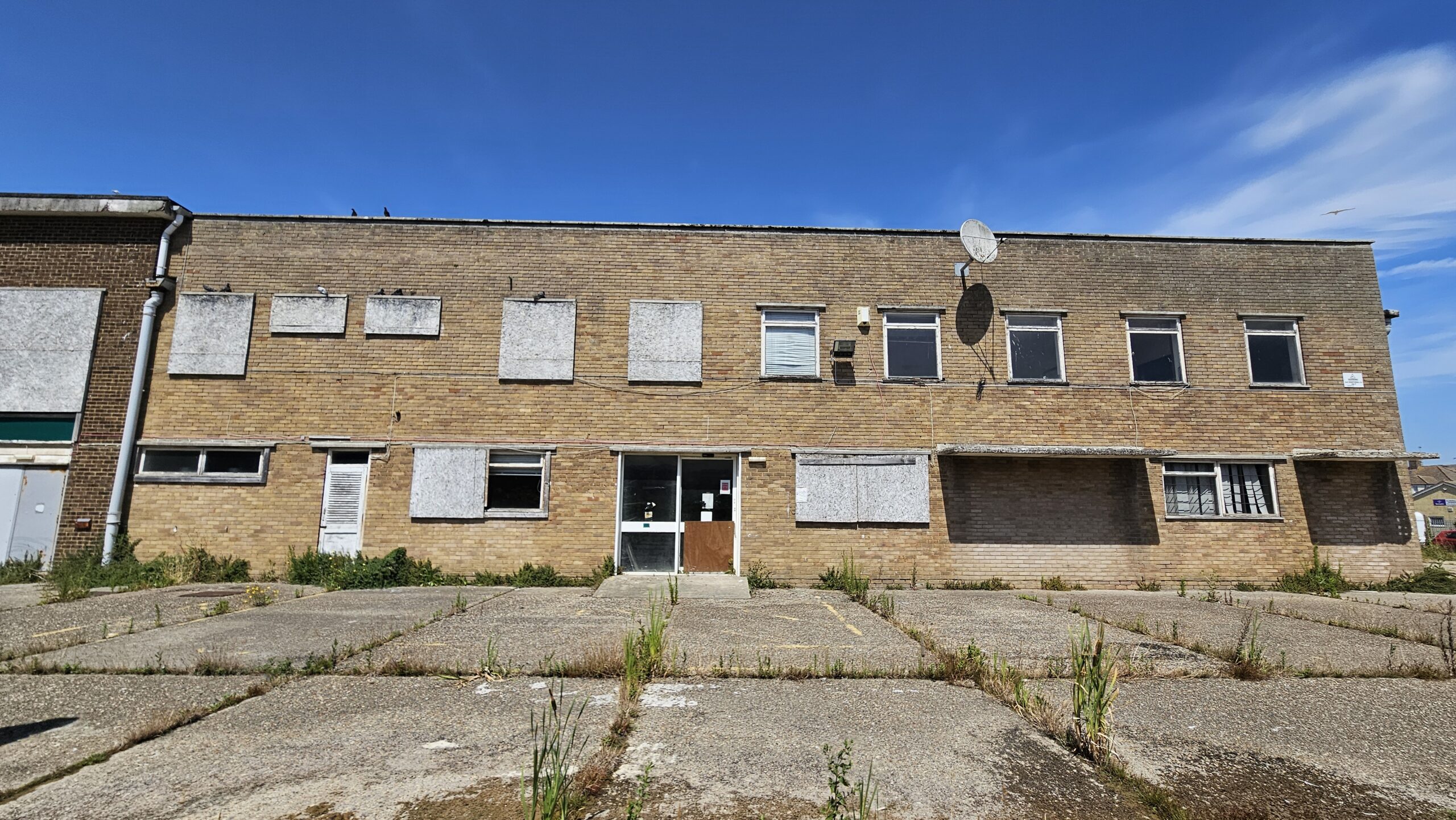

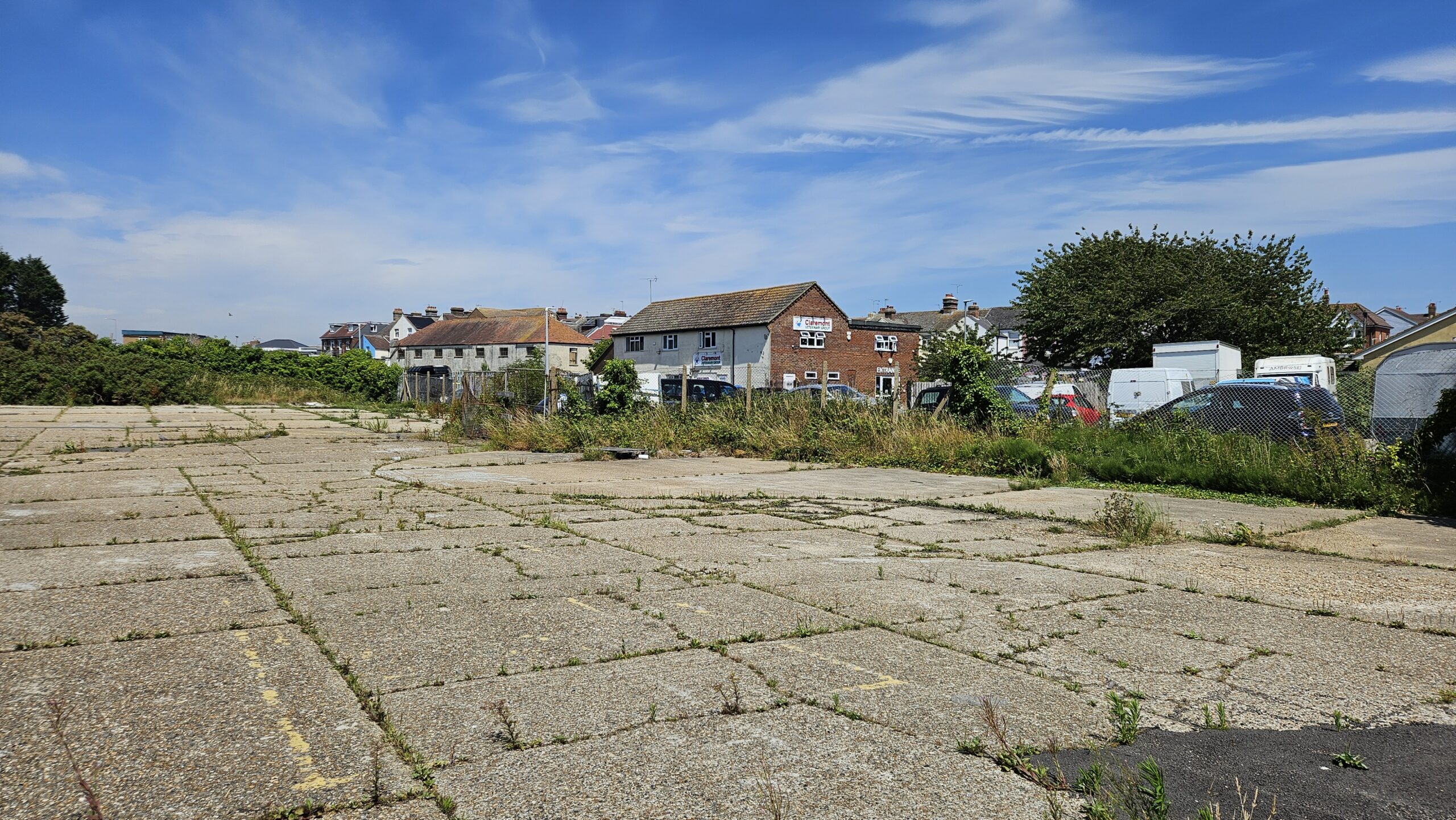

Photo of Skinners Shed Warehouse

Project Timeline

The proposed project timeline is as follows:

Key MilestonesMilestone Date
Funding Approved03/02/2025 (Cabinet Reference CB24/70)
Prior Approval Application ApprovedOctober 2025
Demolition CommencementMay 2026
CompletionJuly/August 2026

News and Updates

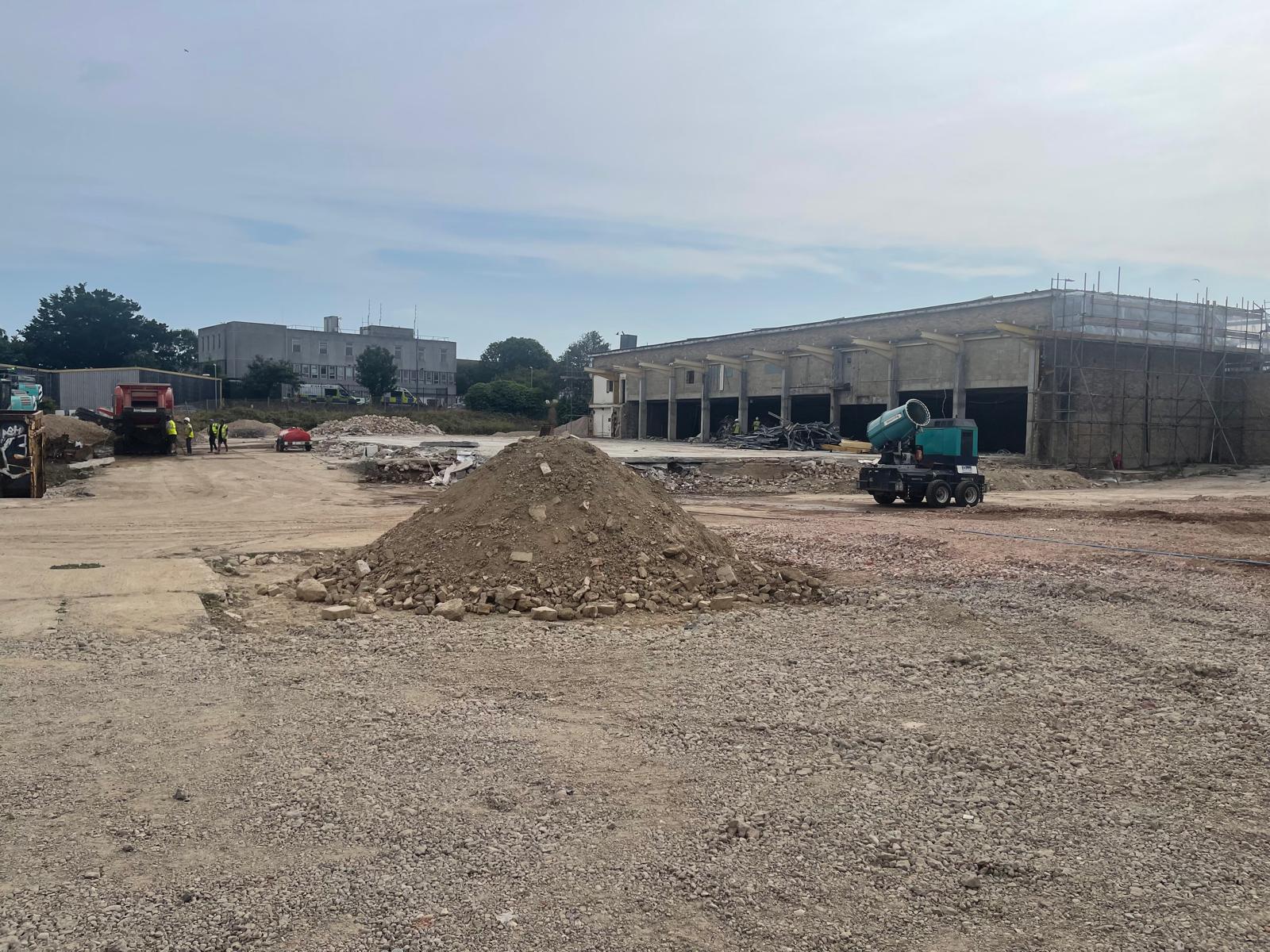

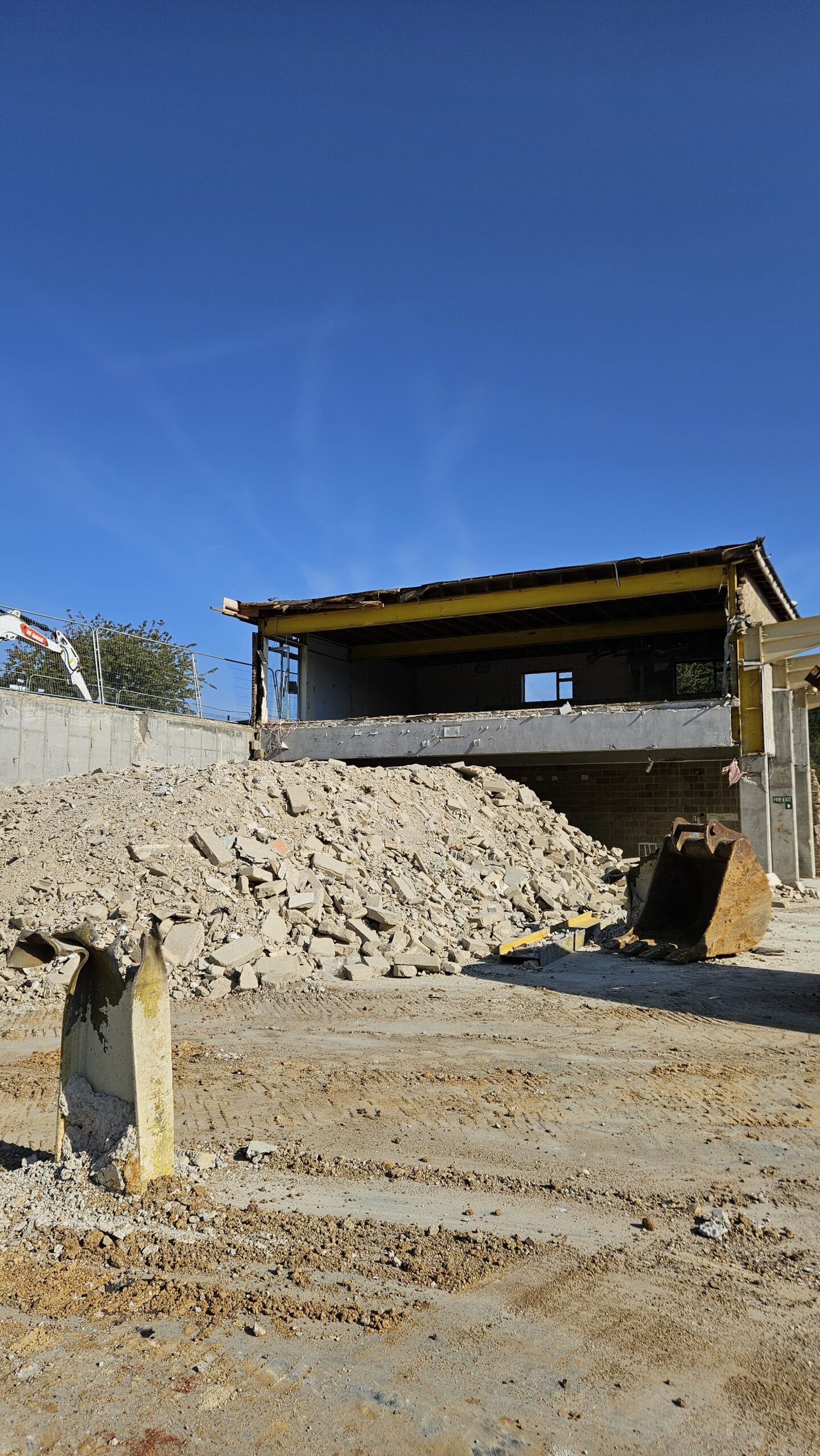

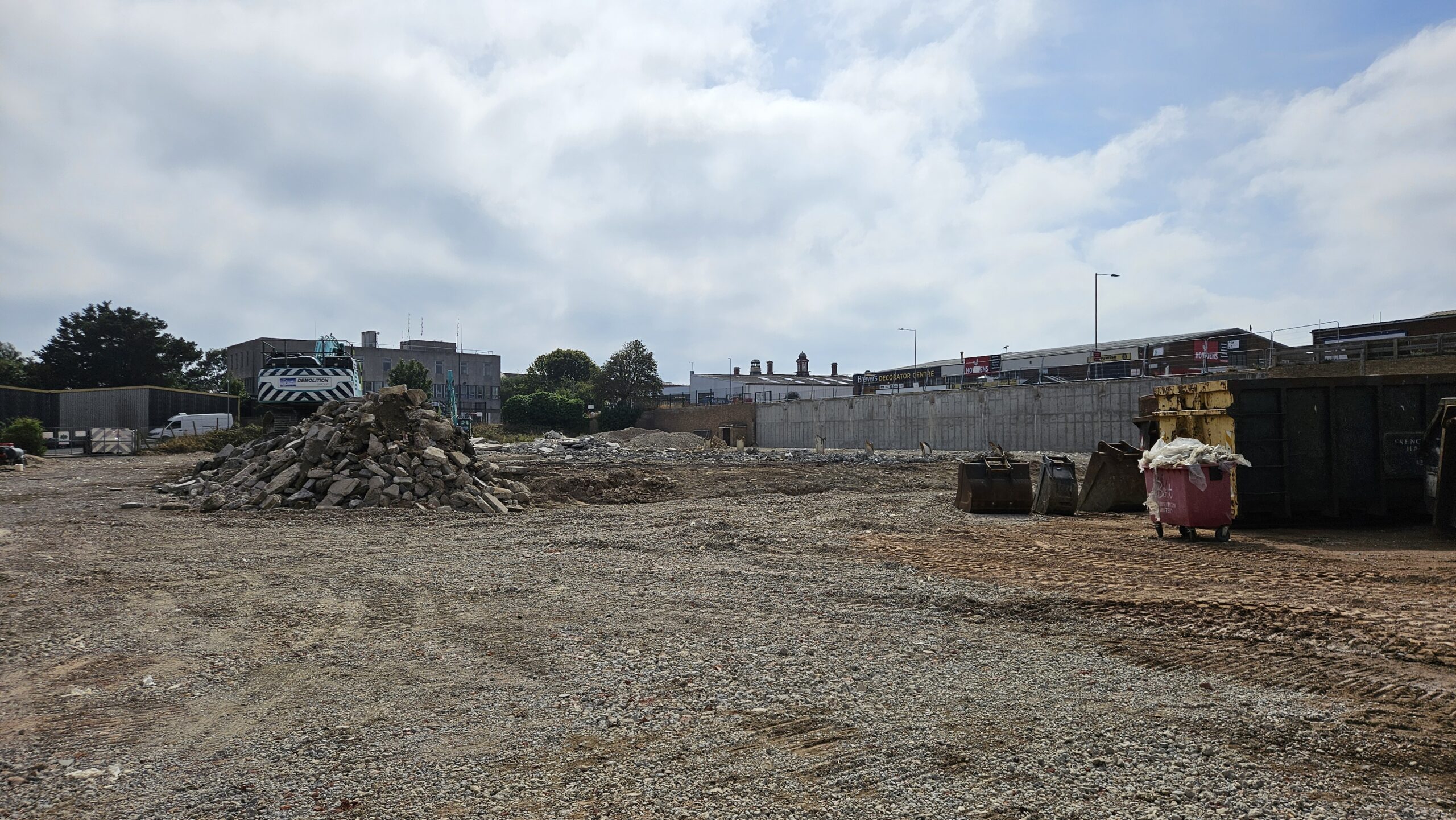

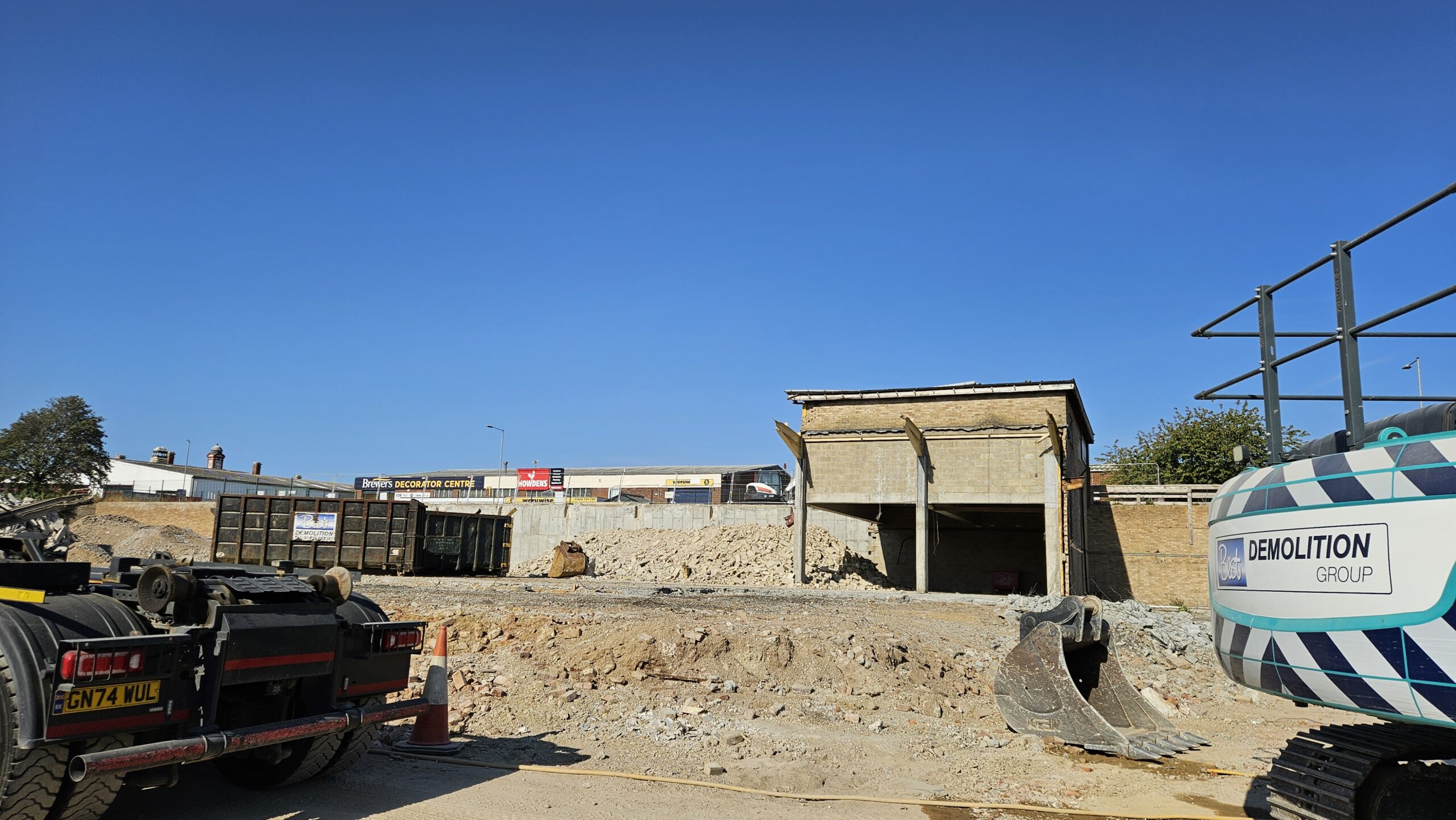

We are pleased to announce that Best Demolition have been appointed as the Demolition Contractor for Skinners Shed!

October Planning Committee concluded that prior approval was not required for the site and that the demolition can ago ahead without submission of further information. The decision can be viewed online here: PL25/46 – RR/2025/1483/DN 35 Beeching Road

An Application for Prior Approval for Demolition was submitted 11/08/2025 to the planning department – details can be viewed online here: RR/2025/1483/DN.

Project Approved at Cabinet

At the Cabinet meeting on 03/02/2025, the Skinners Shed project was formally announced. A budget of £200k was approved.
